Service / 05
Driveway Replacement in North Bay, Ontario
Driveway replacement is a full removal and rebuild: excavate the failing asphalt, concrete, or settled interlock, re-grade the sub-base, install a HPB aggregate base from Northfield Sand and Gravel, and hand-lay a new paver surface with proper edge restraint and polymeric joints. Bouwers Design Landscaping replaces driveways across North Bay and the Nipissing district. Most residential driveway replacements run quote to clean exit in two to four weeks, with the install itself usually inside one week of working time on the property. The interlock surface typically runs $25 to $32 per square foot in 2026; demolition and haul-off of the existing surface is a separate quote line. Every project carries the Bouwers 5-year workmanship warranty plus the full manufacturer warranty from Techo Bloc, Permacon, Oaks, Browns, or Bestway Stone on the pavers themselves. Service area: North Bay, Callander, Powassan, Corbeil, Astorville, Bonfield, Sturgeon Falls, Mattawa, Trout Creek, Sundridge.
Last updated 2026-05-25
Built Elegance
The old driveway gets removed. The new one is built on a base the climate respects.
Why driveways fail in North Bay
Asphalt, concrete, and old interlock all fail for predictable reasons. Replacement is the right answer when the base, not just the surface, is gone.
A driveway in Northern Ontario sees roughly 120 freeze-thaw cycles a year. Every surface bonded to or sitting on the ground expands and contracts through every one of those cycles. Asphalt cracks under freeze-thaw stress within a decade because the binder hardens and the surface loses flexibility. Once the cracks open, water gets under the surface, freezes, lifts, and the cracks widen. Concrete heaves above the frost line because concrete slabs are rigid; if any part of the sub-base sits in the frost zone, the slab gets pushed up by frozen soil and drops again on thaw, and the slab cracks or tilts. Interlock driveways fail when the original install was undersized: too-thin a base, missing edge restraint, or generic mason sand in the joints instead of polymeric.
The failures all show up the same way on the surface: cracking, settling, joint washout, edge spread, and the visual sag at the bottom of a slope where water collects. Failed edge restraints cause paver migration: the entire perimeter starts to creep outward into the lawn, joints open up, and the surface looks rumpled within five years. Joint washout is the small one most homeowners notice first because it shows up after a single heavy rain.
The question on every site visit is not what the surface looks like. It is what is under the surface. A driveway with a cracked asphalt surface but an intact, properly compacted gravel base is a re-pave conversation. A driveway with a sunken surface, washed-out joints, and an edge that has crept four inches into the lawn is a base failure. Base failures need a full replacement, not a re-surface. Bouwers Design Landscaping diagnoses which one a property has during the site visit and quotes accordingly.
What replacement actually looks like
Driveway replacement is not a re-surface. The entire existing driveway is removed and the new one is built up from the sub-grade.

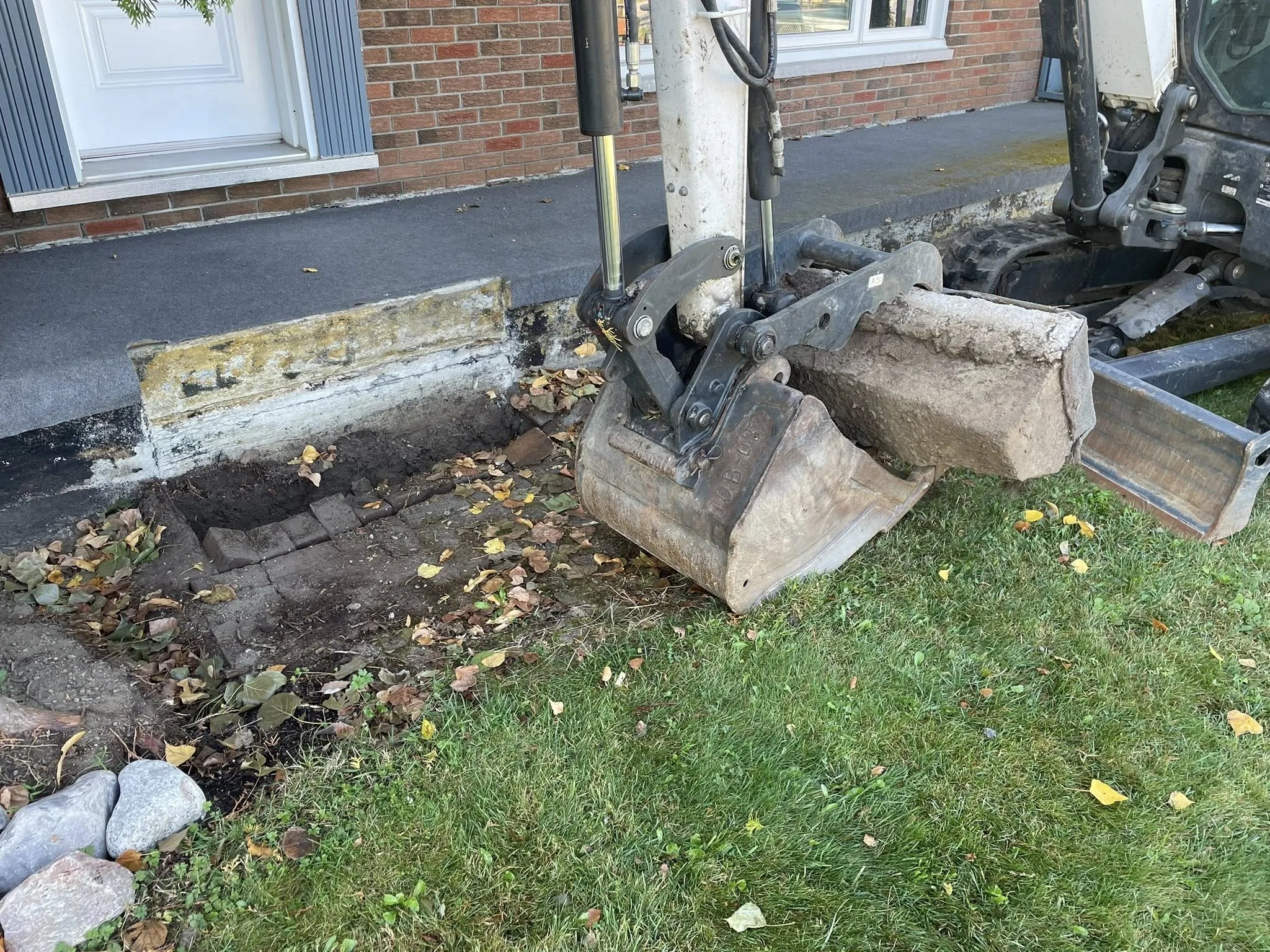

The first morning on a Bouwers Design Landscaping driveway replacement starts with a saw cut and a small excavator. Asphalt is scored along the perimeter, broken into slabs, and loaded into a haul-off truck. Concrete is broken with a hydraulic hammer and removed in larger pieces. Salvageable existing interlock, if the homeowner wants to retain the pavers and the originals are in good shape, is lifted course by course and palletized on the lawn for reuse or resale. Most failed interlock driveways are not worth salvaging because the wear pattern, the joint washout, and the surface chipping have caught up with the pavers.
Once the surface is gone, the excavation drops deeper than the original. Most driveways in North Bay built before 2010 sit on a base that is too thin by current freeze-thaw spec, which is part of why they failed in the first place. The new excavation depth is set by the paver manufacturer's spec, the soil type, and the load (a typical residential driveway calls for a base depth that puts the assembled build close to or below frost depth at the perimeter). Sub-grade is then re-graded to drain water away from the home rather than toward it.

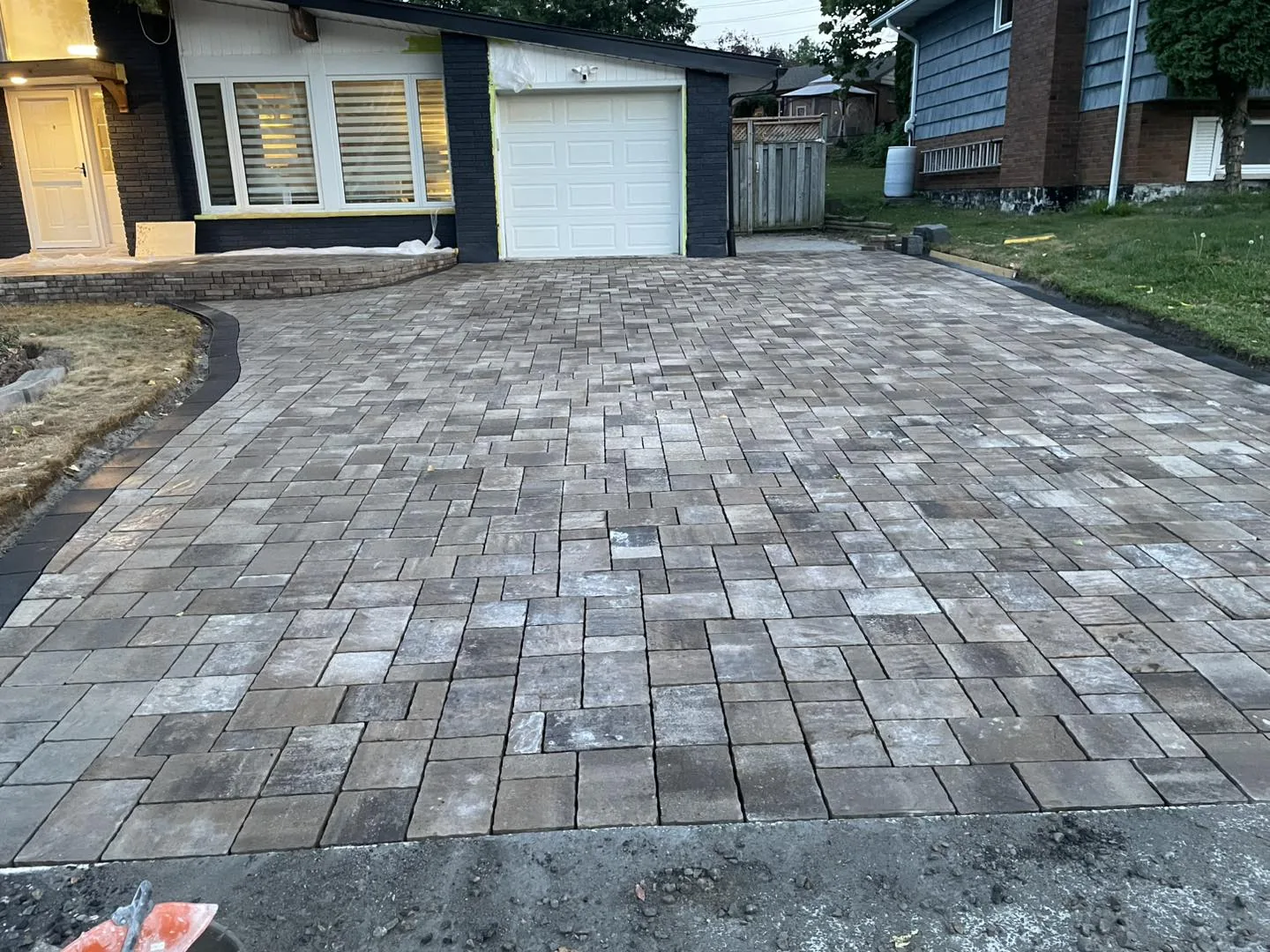

From there it is base, paver, joint, compact, walkthrough. The base is HPB (High Performance Bedding) sourced through Northfield Sand and Gravel, plate-compacted in lifts to the density Techo Bloc and Permacon require for full manufacturer warranty coverage. The paver layer is hand-set by the small crew of two to four, cuts made with a wet saw, polymeric joint sand activated with water, edge restraint locked along every free edge. The driveway looks finished on day five or six; the polymeric joints cure for another twenty-four hours before the homeowner drives on it.
City of North Bay disposal protocols govern where the waste goes: asphalt is recycled into a base aggregate product at a local recycler, concrete is crushed for use as fill, and any contaminated soil flagged during excavation is handled separately. Nothing ends up at the curb.
How a Bouwers driveway gets replaced
Eight steps. Permit coordination, demolition haul-off, base, paver install, and warranty paperwork are all on the Bouwers Design Landscaping side.
-
01
Site visit and written quote
Dylan visits, measures the driveway, identifies the existing surface and base condition, checks grade and drainage, and issues a written quote listing demolition, excavation, HPB base, paver selection, concrete edging, polymeric joints, and any permit cost.
-
02
Deposit and schedule
On signed acceptance, a deposit holds the build slot. Spring schedule fills quickly. Fall installs are available with a weather contingency clause covering polymeric joint cure.
-
03
Locates and access prep
Ontario One Call locates booked for utilities. Plywood path laid to protect lawn, walkways, and adjacent hardscape from equipment traffic during demolition and excavation.
-
04
Demolition and haul-off of the old driveway
Asphalt saw-cut and broken out. Concrete hammered and removed. Salvageable interlock palletized for reuse or resale. All waste hauled to the appropriate City of North Bay-approved disposal site.
-
05
Excavation and grade reset
Excavation reaches the depth specified for the new build, deeper than the original on most projects. Sub-grade is checked, soft spots removed, and grade is reset to drain water away from the home.
-
06
HPB aggregate base in compacted lifts
HPB (High Performance Bedding) from Northfield Sand and Gravel goes in as the new base, in lifts, plate-compacted to manufacturer-spec density. This is the spec Techo Bloc and Permacon require for full manufacturer warranty.
-
07
Hand-laid paver install and edge restraint

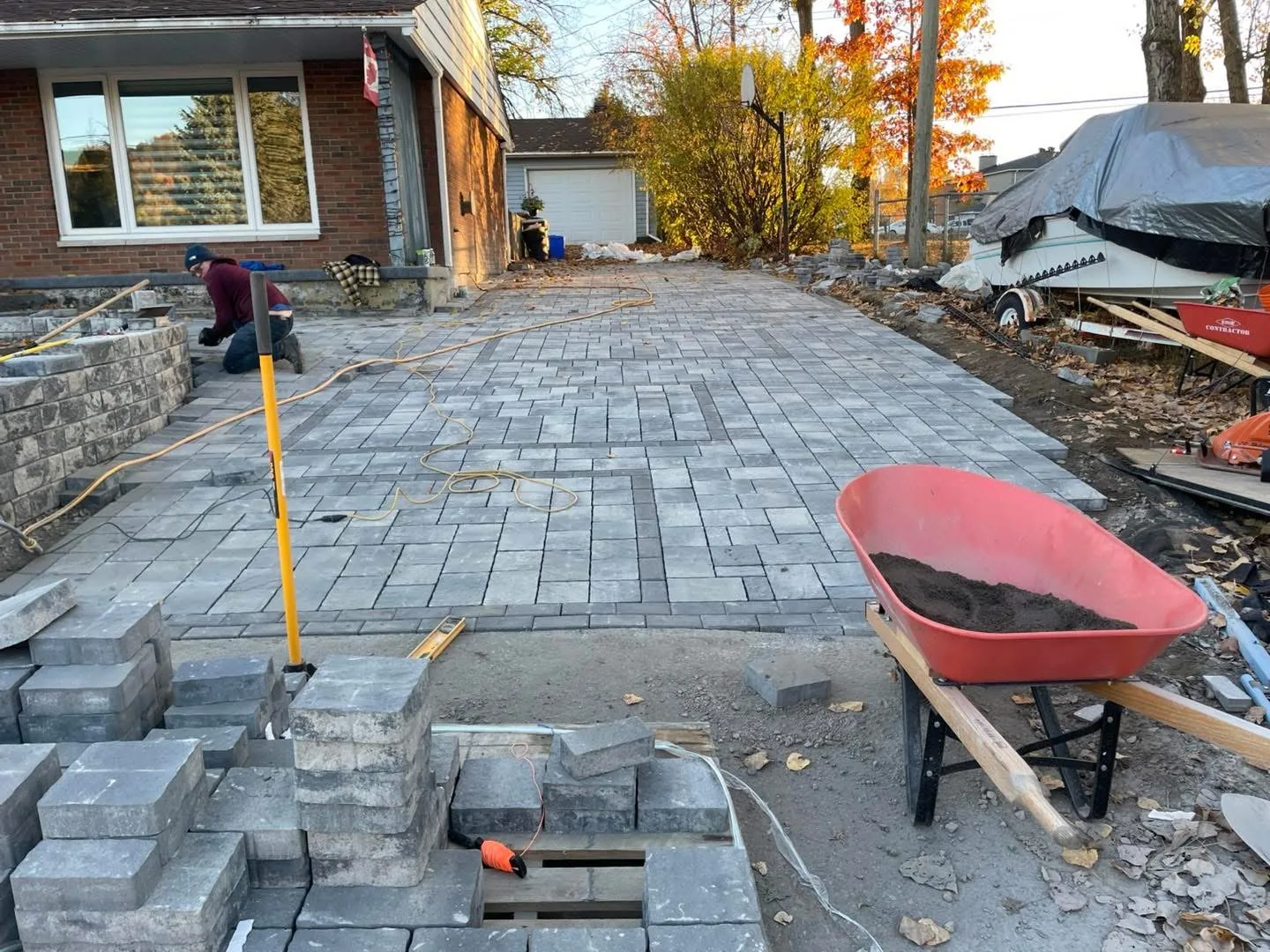

Pavers hand-laid in the specified pattern. Cuts made with a wet saw. Concrete edging poured along every free edge so the surface cannot creep outward over time.
-
08
Polymeric joint, compaction, walkthrough
Polymeric joint sand swept into joints, activated with water. Surface plate-compacted with a paver protector. Site cleaned. 5-year workmanship warranty handed over with manufacturer warranty registration on the pavers.
Driveway pavers we install
Five brands carried on every quote. Driveway lines are heavier and thicker than patio lines for a reason: vehicle load.
-
Techo Bloc
Wide range of driveway-rated paver lines, from contemporary smooth-face systems to traditional tumbled-edge looks. Driveway lines are minimum 60 mm thick and engineered for vehicle load. Bouwers Design Landscaping is set up for the warranty registration that Techo Bloc requires on every install.
-
Permacon
Quebec-made paver lines popular for driveways with strong cold-climate field history. Driveway-grade lines stand up to plows and salt without surface degradation. Several lines pair well with matching wall block when the driveway sits between retaining walls.
-
Oaks Landscape Products
Ontario-based with a deep driveway paver catalog. Multiple lines hold up well to vehicle traffic and freeze-thaw cycling. Common pick on properties where the homeowner is matching an existing Oaks product elsewhere on the site.
-
Browns and Bestway Stone
Browns concrete and masonry products and Bestway Stone paver lines round out the catalog. Both are realistic options where a specific colour, texture, or budget point steers the selection away from the bigger three brands.
Timing and pricing, in writing
Driveway replacement runs on a tight schedule. The number on the quote is the number on the invoice unless the site reveals something not visible on day one.
Timing. Most residential driveway replacements run quote acceptance to clean exit in two to four weeks. The install itself typically takes five to eight working days on the property: day one for demolition and haul-off, day two for excavation and grade reset, days three and four for HPB base in compacted lifts, days five through seven for paver install, day eight for polymeric joints, compaction, and walkthrough. Rain delays compaction and polymeric joint activation; weather contingency days are baked into the schedule and noted on the quote. Spring (May and June) books out the fastest; fall installs from September through mid-October are common and carry the same warranty.
Pricing. The interlock surface itself typically runs $25 to $32 per square foot in 2026, depending on paver line and cut complexity. Demolition and haul-off of the existing driveway is a separate quote line; removing asphalt is generally less expensive than removing concrete, and salvageable existing interlock can offset cost if Dylan and the homeowner agree to retain the pavers for reuse or resale. Typical residential driveway replacement projects land in the $15,000 to $30,000 range, with larger or more complex driveways running higher. The number on the quote is line-itemed in writing after the site visit. Verbal estimates are not given over the phone because they are not reliable.
Where we replace driveways
Bouwers Design Landscaping replaces driveways across North Bay and the surrounding Nipissing district. City-specific pages cover local conditions, permit context, and example projects.
Warranty and supplier stack
Every replacement is covered top to bottom: the manufacturer warranty on the paver, the workmanship warranty on the build.
Every Bouwers Design Landscaping driveway replacement carries a 5-year workmanship warranty covering settlement, joint failure, and edge restraint failure under normal residential use. The full manufacturer warranty on the pavers (Techo Bloc, Permacon, Oaks, Browns, or Bestway Stone) stacks underneath. The combined coverage means the finished driveway is protected from the HPB base up through the surface. The warranty page covers the exact scope, exclusions, and the claim process.
Aggregate base is sourced from Northfield Sand and Gravel (the HPB (High Performance Bedding) spec) and Degagne Aggregates. Pavers come through OCP and the manufacturer's local distributors. See the suppliers page for the full supplier list and the rationale behind each.
Driveway replacement in North Bay, answered directly
The five questions every homeowner asks before signing a driveway replacement contract.
How long does the demolition and new install take?
Can you replace just part of a failing driveway?
What happens to the old asphalt or concrete from my driveway?
Do I need a permit to replace a driveway in North Bay?
Ready to replace the driveway?
Send the basics: square footage, existing surface, and the address. Bouwers Design Landscaping responds same-day during build season, usually within a couple of hours. Site visits are no-charge inside the tight-cluster service area.
